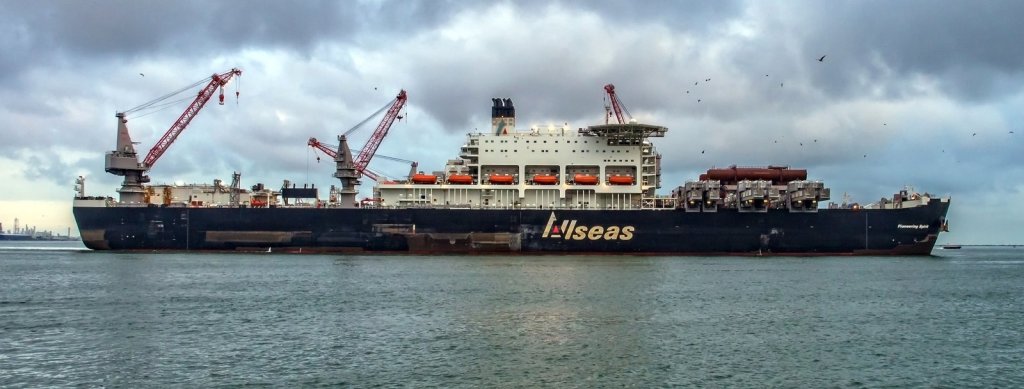

Pioneering Spirit at Maasvlakte 2, Rotterdam, on 6 August 2016, showing the vessel's early operating configuration. Photo: BsnarF1, via Wikimedia Commons, CC BY 2.0. Cropped and optimised by the Commons uploader; watermark removed in the Commons version. Resized and compressed for publication.
Pioneering Spirit took 8 hours 56 minutes to position her lifting beams around Shell’s Brent Delta platform, then lifted its topsides, an estimated 23,500 tonnes, clear in a 15-second fast lift. The 382-metre Allseas vessel straddles a platform in her split bow and removes or installs topsides in a single piece. Allseas marked ten years of single-lift work in August 2026.
| Item | Allseas published rating or dimension |
|---|---|
| Hull length and breadth | 382 metres; 124 metres |
| Bow slot | 122 metres long; 59 metres wide |
| Equipped overall length | 477 metres, including stinger and lifting beams |
| Topsides capacity | Up to 60,000 tonnes |
| Jacket capacity | Up to 20,000 tonnes |
| S-lay tension capacity | 2,000 tonnes |
| Positioning | 12 azimuth thrusters; DP3 |
What she lifts
The topsides contain a platform’s working facilities: equipment, decks, services and, depending on the installation, accommodation or drilling systems. Their support may be a steel jacket extending to the seabed or a concrete gravity-based structure.
A steel jacket is an open framework whose connections to the seabed must be addressed before recovery.
Allseas rates her at up to 60,000 tonnes for topsides and 20,000 tonnes for jackets.
The 2026 specification lists a 382-metre hull. The longer 477-metre equipped measurement includes projecting lifting beams and the stinger.
Preparation
A structure prepared for removal needs a credible account of its mass, centre of gravity and load paths.
For Pioneering Spirit, the bow slot allows the vessel to approach around the platform support. The ship must then hold a suitable position while the beams are brought into place. Twelve azimuth thrusters support dynamic positioning, with DP3 denoting a demanding redundancy standard.
The lift
Allseas describes 16 topsides lifting beams with three-axis motion compensation and a four-metre fast-lift stroke. The equipment first has to engage the prepared lifting points and establish the intended distribution of load.
As load transfers to the ship, ballast management changes the vessel’s buoyant condition. The fast-lift stage then provides rapid separation and clearance. Once the structure is free, the operating problem changes again: it is now a transported load that must remain supported during the voyage.
Brent Delta
Shell’s close-out report gives the mass with an uncertainty of plus or minus 5 percent, and counts the 8 hours 56 minutes from entering the 500-metre zone.
The report describes progressive deballasting to transfer load, hydraulic separation and further deballasting to gain clearance. Publicity accounts gave 24,200 tonnes and ten seconds; the close-out report is the final record.
Jackets and installations
Pioneering Spirit’s jacket arrangement uses two 170-metre lifting beams at the stern. Allseas describes a sequence in which the jacket is lifted after pile cutting, brought into alignment with the beams and reclined for transport. This is distinct from lifting topsides through the bow slot.
The Ninian Northern project demonstrates the separation of tasks. The topsides were removed in 2020 and the jacket in 2022. Lerwick Port Authority’s contemporary account, dated 22 April 2022, describes an 8,500-tonne, 83-metre jacket arriving for dismantling.
For example, Equinor reported the installation of Johan Sverdrup’s 22,000-tonne drilling topsides in 2018. The company said the topsides were 85% tested, with hook-up still required. Extensive preparation ashore had reduced offshore work; it had not eliminated it.
Allseas also records the installation of West White Rose’s 23,000-tonne topsides on 16 July 2025.
Iron Lady and the shore

The vessel that performs the offshore lift need not be the vessel that reaches the final quay. Draught, channel depth, berth geometry and load-in arrangements can make a separate transport interface essential.
Iron Lady provides a barge interface for transferring large structures between Pioneering Spirit and shore facilities. Its usefulness lies in connecting different operating environments: the offshore lifting vessel and the shallower or more constrained route to a receiving site.
Pipelay

Pioneering Spirit’s 2,000-tonne S-lay tension capacity refers to holding and controlling a pipeline during installation.
In Allseas’ explanation of offshore pipelay, pipe sections are assembled aboard and the growing line is lowered towards the seabed. In S-lay, the supported and suspended portions form the characteristic change in curvature between the vessel and the seabed.
The stinger supports the departing pipe, while tension helps control its suspended shape. Excessive bending can damage a pipeline even if its material is strong in other forms of loading. Installation therefore requires control of geometry and forces as the vessel advances.
Grand Tour
The current 60,000-tonne topsides rating supersedes the older 48,000-tonne figure still encountered in historical descriptions.
Allseas’ 22 September 2026 announcement about Grand Tour illustrates further work on those interfaces. Steel cutting began at Guangzhou Shipyard International on 16 September, with delivery scheduled for the first quarter of 2028.
Grand Tour, the transport vessel designed to fit inside Pioneering Spirit’s bow slot, is due for delivery in the first quarter of 2028.
